Phasing of work

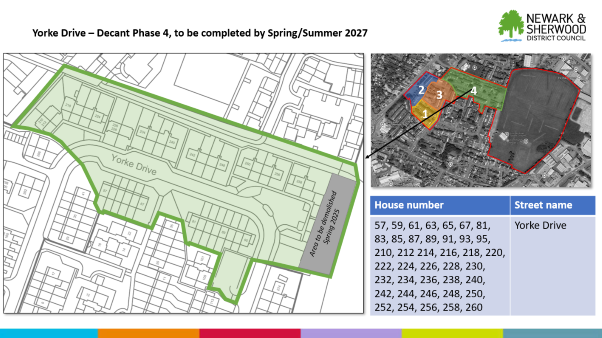

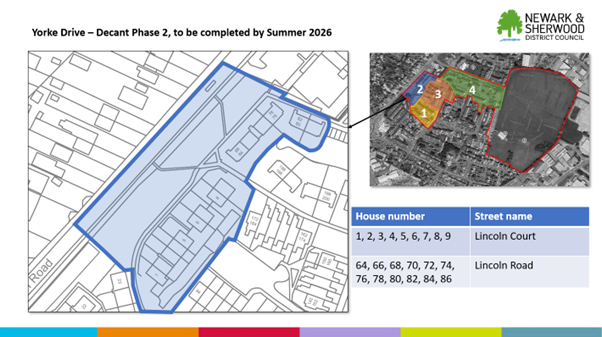

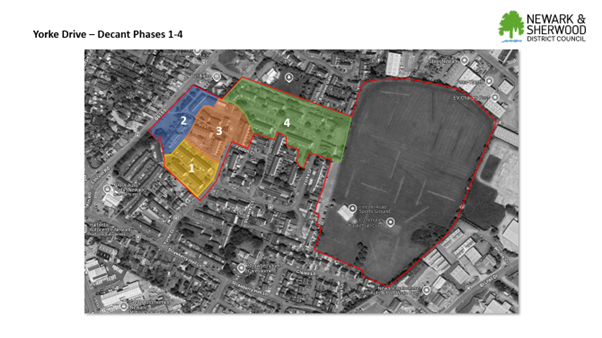

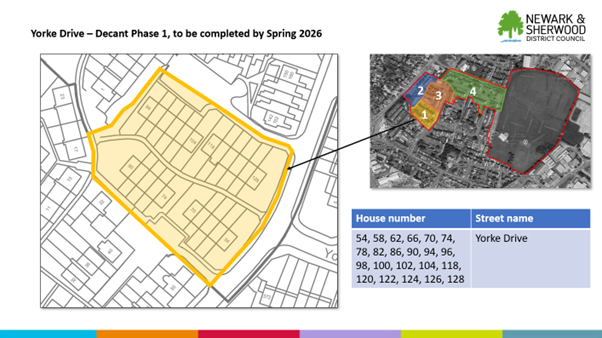

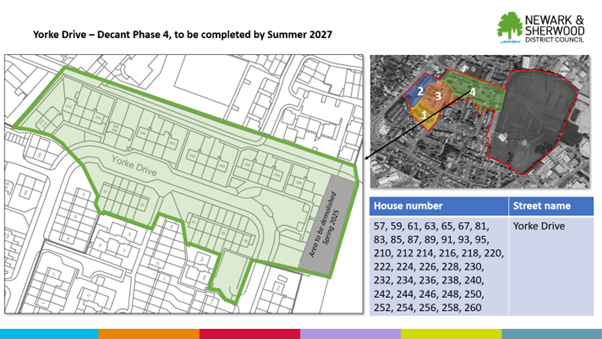

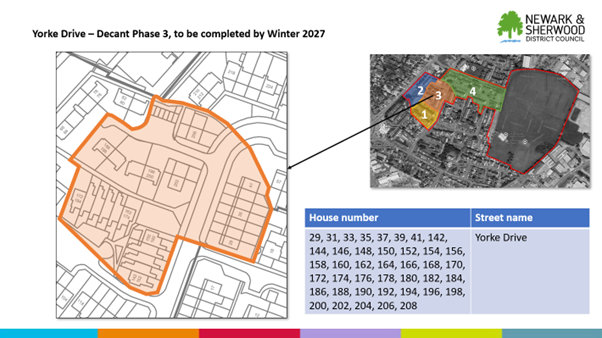

Due to the scale of the regeneration project and the aim to only move tenants once, we will be building the new affordable homes first on the existing playing fields and then moving tenants into their new homes across four phases. Demolition of the existing homes will only take place once all tenants have been moved from their phase.
The images below indicate which houses are in each phase and show an indicative date that tenants will be moved by. Please note, the date shown is the latest point by which tenants will be moved by and it is likely that house moves will take place well in advance of this end date. Further information on dates and the logistics of moving will be shared in due course.
